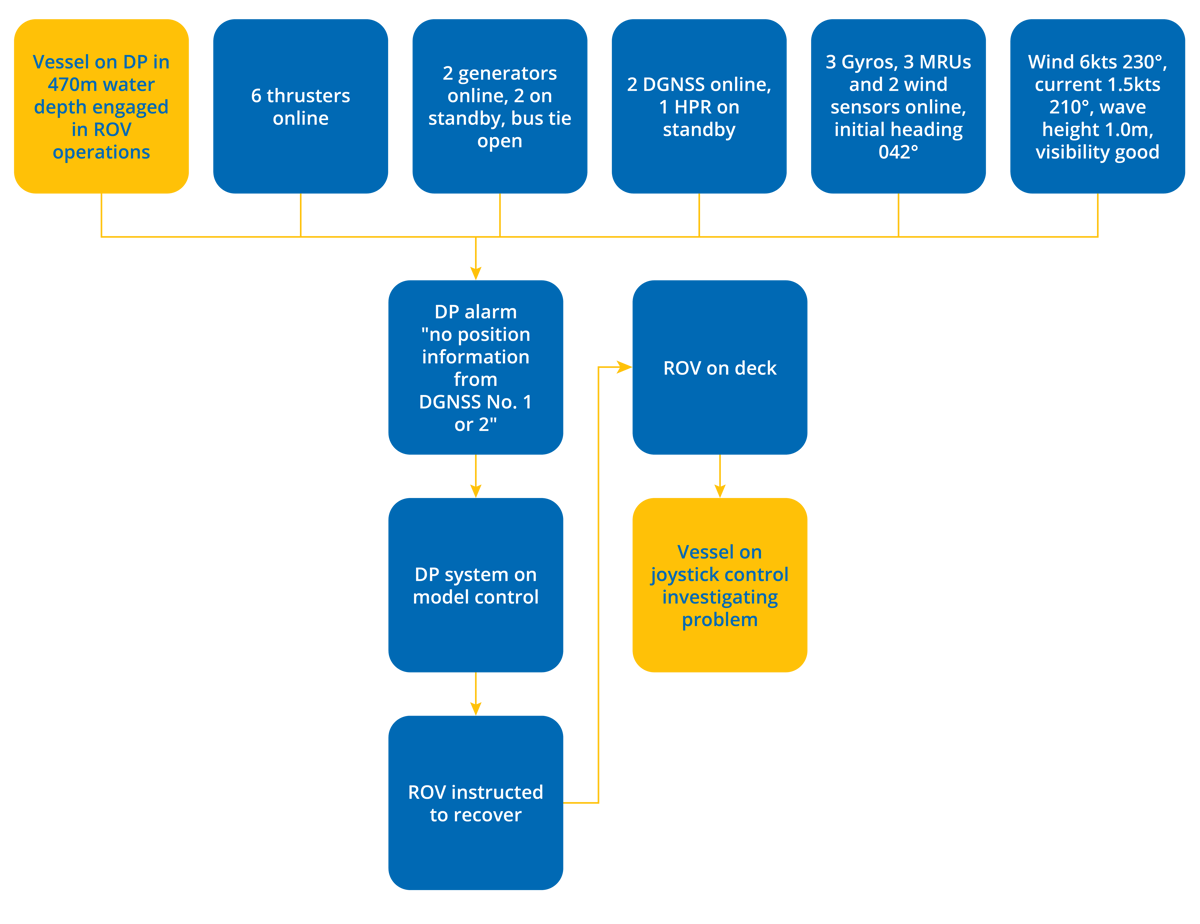

Loss of DGNSS resulted in ROV being recovered
- DP Event
- Published on 2 June 2017
- Generated on 17 May 2026
- DPE 02/17
- 2 minute read
Incident
Jump to:
When considering redundancy of satellite systems do not just consider the manufacturer, but also correction type and transmission method.
Comments
Both the satellite positioning systems in use were from the same provider.
The report recognised this and recommended that the systems were changed so that position information was provided by different service providers.
The service provider informed the operator after the event that its services experienced periods of increased latencies for just over twenty minutes on the day and time of the incident.
Considerations
- It would appear from the information available that the standby hydroacoustic position reference (HPR) system did not have an acoustic transponder on the seabed. In any event it was not utilised.
- Proper consideration should always be made of the required PRS based on the specific operation and the DP equipment class of the vessel.
- When considering redundancy of satellite systems do not just consider equipment manufacturer and software versions; the correction type and transmission method should also be different.
- It is noted that two separate vendors could use correction details from the same source, therefore users should compare what correction type is being used.
- In similar situations users could consider switching to raw global navigation satellite system (GNSS) data, therefore staying on DP but with a larger footprint.
Latest DP incidents
-
Think twice. Press once!
On a DP equipment class 2 supply vessel engaged in drilling, an incident occurred due to lack of operational knowledge
DPE 01/26
11 May 2026
Incident
-
Network issues, not a thing of the past
A DP equipment class 3 vessel was engaged in saturation diving activities, with two divers in the water when this DP incident occurred.
DPE 01/26
11 May 2026
Incident
-
All swept up
A DP equipment class 2 vessel was engaged in rock placement operations, within close proximity to a structure, when this event occurred.
DPE 01/26
11 May 2026
Undesired event
-
Hybrid system won't accept load
A DP equipment class 2 vessel was engaged in operations whilst holding position on auto DP, when this undesired event occurred
DPE 01/26
11 May 2026
Undesired event
-
DP drill scenario – Loss of main DP system UPS
The objective of this scenario is to identify risks and impacts of losing the main DP system uninterruptible power supply, possibilities to reduce that risk and suitable actions to be taken if such an occurrence happened.
DPE 01/26
11 May 2026
Drill Scenario
The case studies and observations above have been compiled from information received by IMCA. All vessel, client, and operational data has been removed from the narrative to ensure anonymity. Case studies are not intended as guidance on the safe conduct of operations, but rather to assist vessel managers, DP operators, and technical crew.
IMCA makes every effort to ensure both the accuracy and reliability of the information, but it is not liable for any guidance and/or recommendation and/or statement herein contained.
Any queries should be directed to DP team at IMCA. Share your DP incidents with IMCA online. Sign-up to receive DP event bulletins straight to your email.
