The cascade effect
- DP Event
- Published on 3 April 2024
- Generated on 13 December 2024
- DPE 01/24
- 3 minute read
Incident
Jump to:
A critical incident aboard a DP vessel, five years post-construction, which experienced a significant power management failure.
The incident unfolded during what was considered ‘routine’ maintenance in the engine room and led to a series of cascading failures impacting the vessel’s power supply and propulsion control.

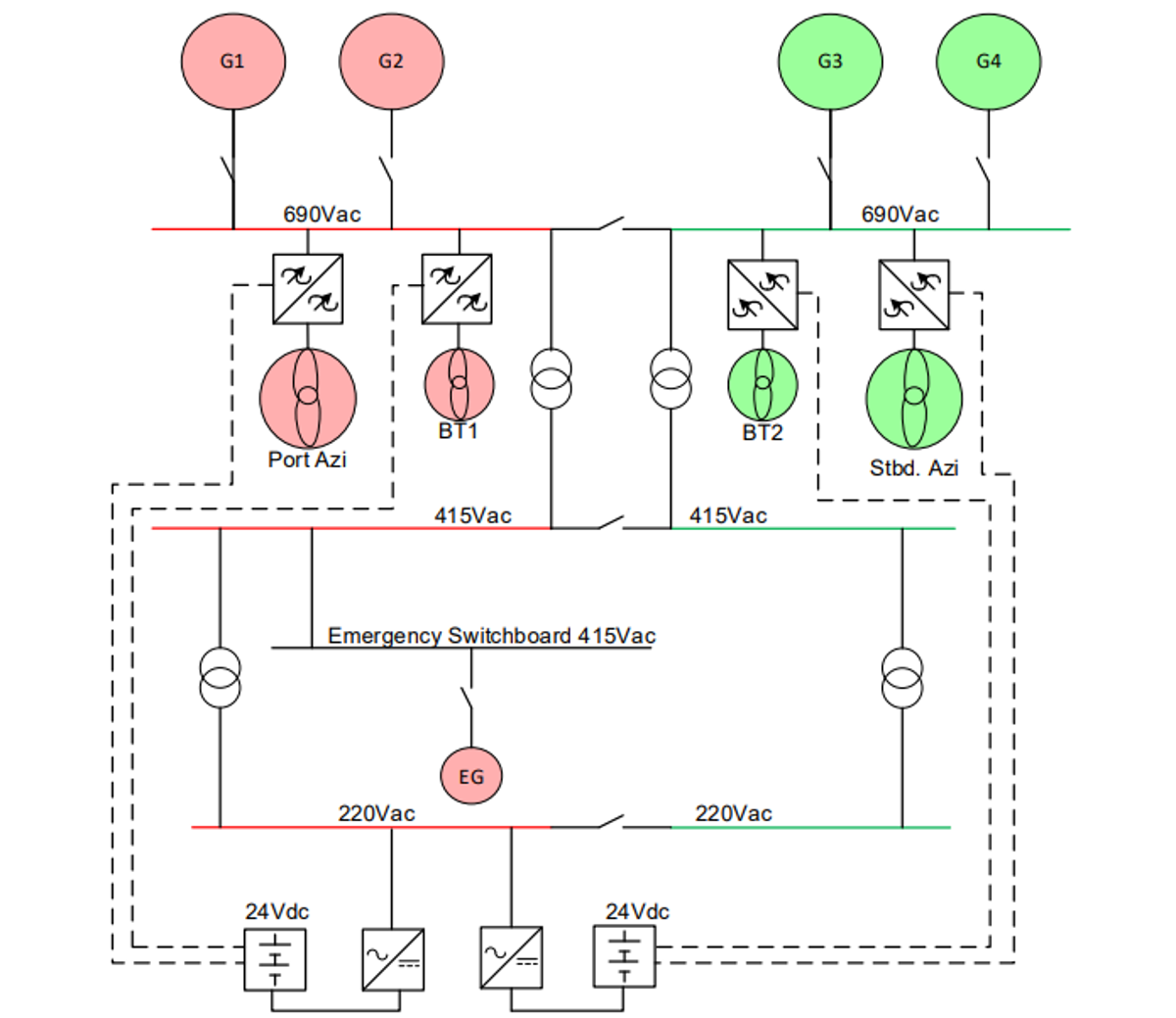

Figure – Overview of power system:
What happened?
The incident initiated when the engine room watchkeeper attempted to replace the left filter of the duplex fuel oil filter of Diesel Generator (DG) No. 1. This generator, integral to the port redundant system, was responsible for powering the 415v and 220v bus A and the emergency switchboards.
1) Failure of DG No.1: Following the filter change, DG No. 1 experienced a blackout due to fuel oil starvation, attributable to incorrect operation of the duplex fuel filter.
2) Inadequate Power Supply from DG No.2: DG No.2, also part of the port redundant group, was initiated but failed to supply power to the bus.
3) Emergency Generator Disconnection: The emergency generator did not engage with the emergency switchboard as the breaker was inadvertently left in manual mode, resulting in a loss of power to the emergency bus bar.
4) Battery Failure: Control power for DP essential equipment, typically supported by batteries during such failures, was compromised as the batteries were drained.
5) Design Flaw in Power Distribution: Despite no failure in the starboard redundant group, the loss of all propulsion control power occurred due to a design fault. The 220v AC and 24v DC systems, providing control power for all propulsion, were sourced solely from the port redundant group.
This design flaw was not identified in the Failure Modes and Effects Analysis (FMEA) or during the annual DP trials, the most recent of which was conducted less than three weeks prior to the incident.
Conclusion
This incident underscores the importance of thorough initial FMEAs, tracking modifications, and ensuring up-to-date documentation. It highlights the need for frequent testing of redundancy groups, implementation of a robust permit-to-work system, and the use of precise DP checklists in both engine room and bridge operations. The event serves as a critical reminder of the intricacies and potential vulnerabilities in power management systems on DP vessels, emphasising the need for diligent maintenance, rigorous testing, and proactive design reviews to ensure operational safety and reliability.
This incident underscores the critical importance of precise control and monitoring of DP system modes during sensitive offshore operations. The swift action by the DPO mitigated the potential risks associated with the unintended mode change. The subsequent software modification and procedural reviews enhance the safety and reliability of DP operations, emphasising the need for continuous vigilance and robust system controls in dynamic maritime environments. It also highlights the importance of robust procedures around field entry and activity specific guidelines.
Actions
In response to this incident, several corrective measures were undertaken:
- Prohibition of maintenance on active or passive DP components within 500 metres of an installation to be indicated in the Engine Room DP checklist and handover checklist.
- Permanent modification of the switchboard setup to ensure propulsion control power is
supplied from different redundant groups. - Verification of switchboard setup by two separate watchkeepers.
- Regular DP blackout drills.
- Regular training on switchboard setup.
- Enhanced battery checks and testing routines.
- Review and update of the company’s test and trials programmes.
