Unreliable position reference systems leads to incident
- DP Event
- Published on 29 November 2019
- Generated on 21 September 2026
- DPE 04/19
- 1 minute read
Incident
Jump to:

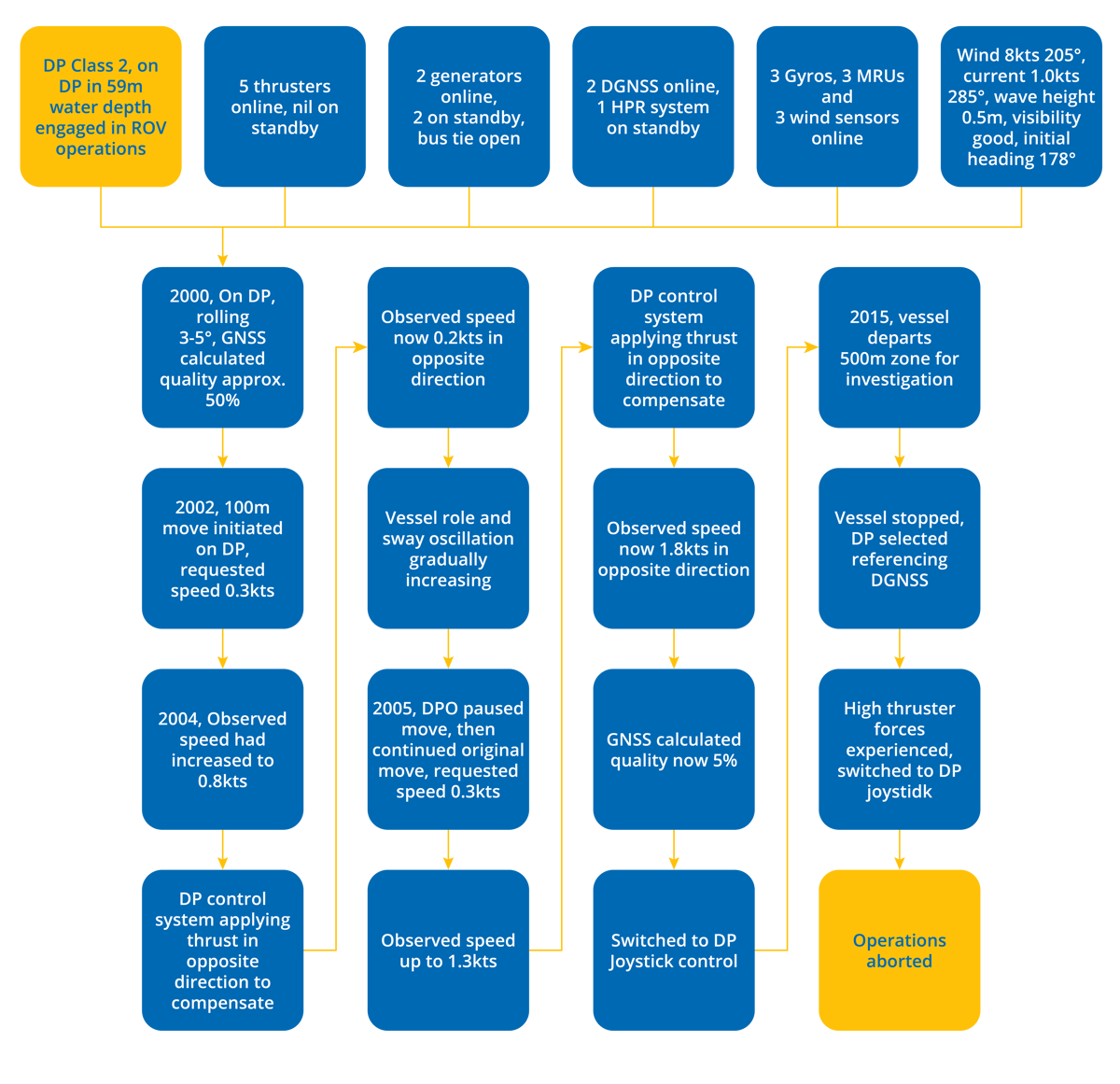

The end-effect was that the deviation from the set point in surge and sway increased with each oscillation.
Comments
Only two DGNSS were online, with poor signal quality due to the location and environmental conditions. The end-effect was that the deviation from the set point in surge and sway were increasing for each oscillation.
Considerations
- For DP2 operations, the use of only two DGNSS systems is insufficient; a minimum of three systems are to be used based on two principles.
- The importance of monitoring the position reference systems (PRS) screen cannot be overstated; this then ensures that all the PRS agree on the position of the vessel.
- It is evident that the selected PRS were not providing reliable position information and highlights the problems that can be experienced when at least one reliable PRS is not available.
- It was noted that the move was paused at 2005; this should have provided the opportunity to investigate and correct the situation rather than continue with the move.
- It is also worth considering that the erratic movement of the vessel could indicate that the DP system needs retuning.
Latest DP incidents
-
Know your equipment, or at least where to find the answers
During an update in the Follow Target Mode, the crew noticed an anomaly with joystick control.
DPE 02/26
1 September 2026
Observation
-
New equipment, unexpected consequences
During the operation, a loss of DGNSS correction signals was experienced across multiple vessel DGNSS units.
DPE 02/26
1 September 2026
Incident
-
A chain of small failures leads to a major consequence
While conducting cargo operations on DP a vessel experienced a partial blackout caused by an unexpected shutdown of generator 3
DPE 02/26
1 September 2026
Incident
-
Holding position, losing references
While approaching a turret-moored, weather-vaning offshore installation (FPSO), in preparation for cargo operations, a DP equipment class 2 vessel experienced significant rolling of up to 15–20° due to a long-period swell close to the vessel’s natural roll period, resulting in a resonance effect
DPE 02/26
1 September 2026
Observation
-
DP drill scenario – Loss of seawater cooling pump redundancy
Exercise scenario – Loss of seawater cooling pump redundancy
DPE 02/26
1 September 2026
Drill Scenario
The case studies and observations above have been compiled from information received by IMCA. All vessel, client, and operational data has been removed from the narrative to ensure anonymity. Case studies are not intended as guidance on the safe conduct of operations, but rather to assist vessel managers, DP operators, and technical crew.
IMCA makes every effort to ensure both the accuracy and reliability of the information, but it is not liable for any guidance and/or recommendation and/or statement herein contained.
Any queries should be directed to DP team at IMCA. Share your DP incidents with IMCA online. Sign-up to receive DP event bulletins straight to your email.
