Incident with assisted mooring
- DP Event
- Published on 14 May 2020
- Generated on 20 May 2026
- DPE 02/20
- 1 minute read
Incident
Jump to:
There appears to be no consideration to the external force being applied to the vessel due to the use of mooring lines when in DP.
Comments

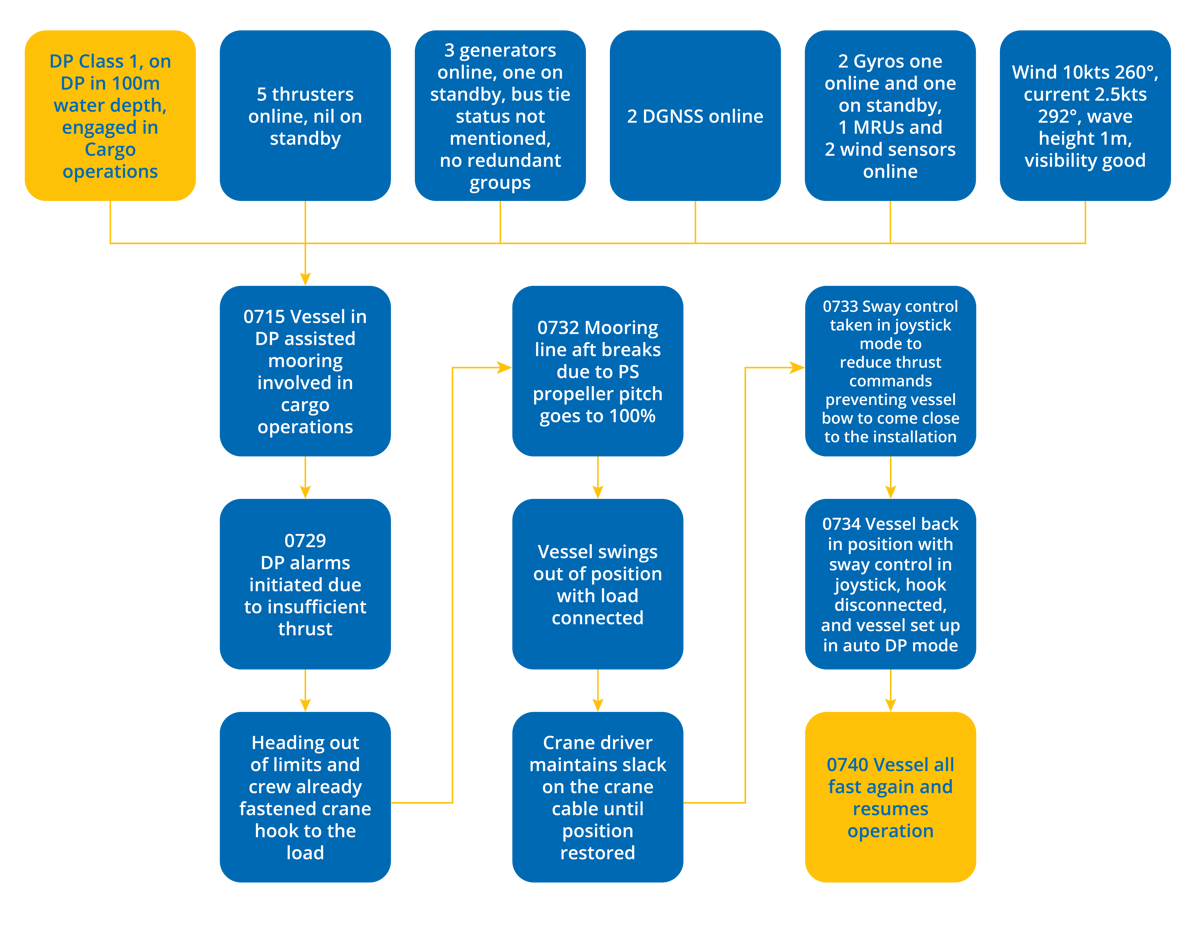

During cargo operations in DP assisted mooring, due to undefined information being fed to the DP system, the pitch on the port propeller increased to maximum. The vessel started to drive off the installation with the crane connected to the load, dimensions 3.5*10.5*6.5 m weighing 11 M Tons. All deck crew were already in safety area behind crash bar ready with tug lines for the lift.
Considerations
- There appears to be no consideration to the external force being applied to the vessel due to the use of mooring lines when in DP.
- If an external force is applied to a DP vessel without feedback and correct configuration within the DP system, it will have unintended consequences.
- It appears an appropriate Activity Specific Operating Guideline (ASOG) was not in use.
Latest DP incidents
-
Think twice. Press once!
On a DP equipment class 2 supply vessel engaged in drilling, an incident occurred due to lack of operational knowledge
DPE 01/26
11 May 2026
Incident
-
Network issues, not a thing of the past
A DP equipment class 3 vessel was engaged in saturation diving activities, with two divers in the water when this DP incident occurred.
DPE 01/26
11 May 2026
Incident
-
All swept up
A DP equipment class 2 vessel was engaged in rock placement operations, within close proximity to a structure, when this event occurred.
DPE 01/26
11 May 2026
Undesired event
-
Hybrid system won't accept load
A DP equipment class 2 vessel was engaged in operations whilst holding position on auto DP, when this undesired event occurred
DPE 01/26
11 May 2026
Undesired event
-
DP drill scenario – Loss of main DP system UPS
The objective of this scenario is to identify risks and impacts of losing the main DP system uninterruptible power supply, possibilities to reduce that risk and suitable actions to be taken if such an occurrence happened.
DPE 01/26
11 May 2026
Drill Scenario
The case studies and observations above have been compiled from information received by IMCA. All vessel, client, and operational data has been removed from the narrative to ensure anonymity. Case studies are not intended as guidance on the safe conduct of operations, but rather to assist vessel managers, DP operators, and technical crew.
IMCA makes every effort to ensure both the accuracy and reliability of the information, but it is not liable for any guidance and/or recommendation and/or statement herein contained.
Any queries should be directed to DP team at IMCA. Share your DP incidents with IMCA online. Sign-up to receive DP event bulletins straight to your email.
