Failure of DP UPS
- DP Event
- Published on 3 September 2019
- Generated on 16 September 2026
- DPE 03/19
- 2 minute read
Undesired event
Jump to:

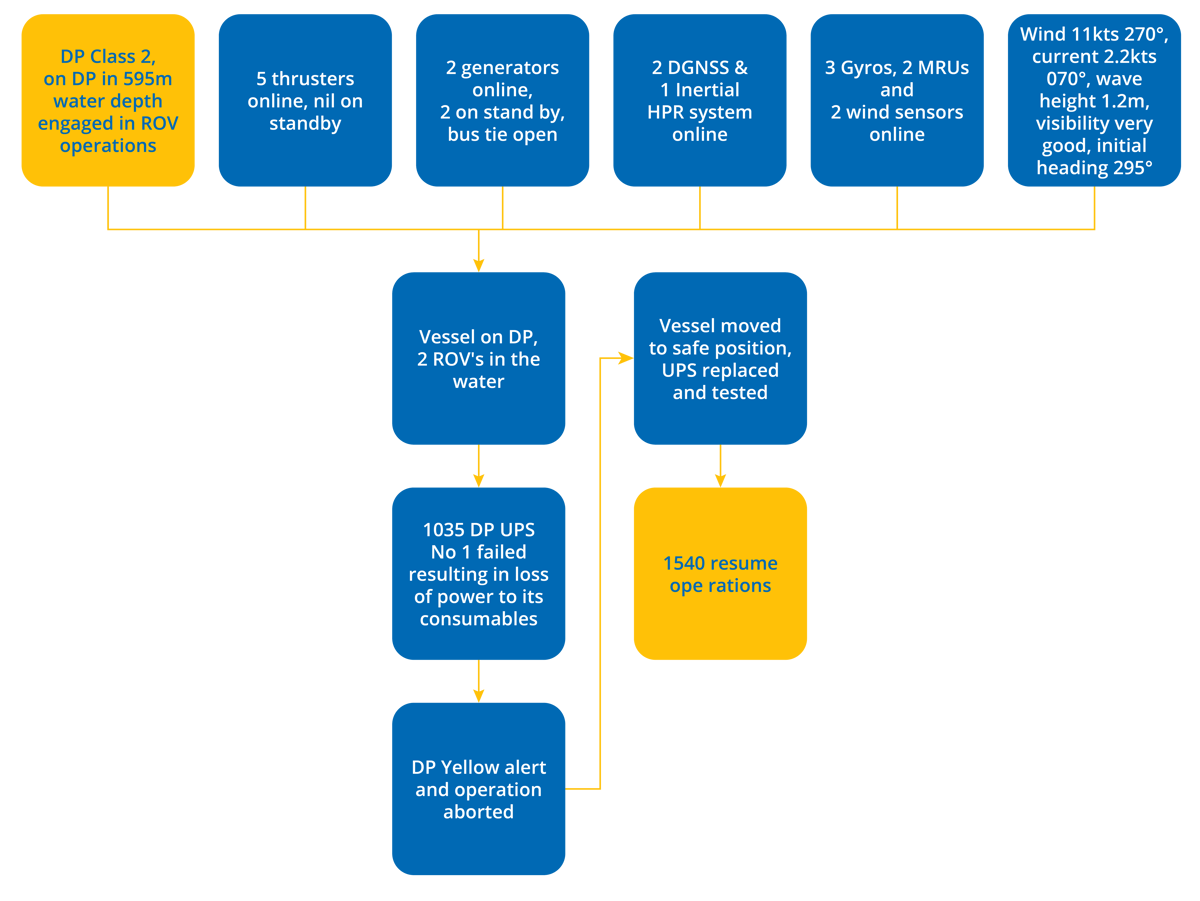

It was noticed that there was a strong burning smell from the UPS which was still powered up from the ship's supply but was in internal bypass.
Comments
The vessel maintained position but DP equipment class 2 capabilities were compromised.
It was noticed that there was a strong burning smell from the UPS. The UPS was still powered up from the ship's supply but it was in internal bypass. Tests were carried out and it was noted that there was no voltage or frequency output. The voltages on the eight external batteries were checked and all but one had 12+ Volts. One of the batteries had 10 volts.
The replacement unit was tested extensively, and it operated satisfactorily.
Considerations
- The status of the UPS should be verified on pre-operational checklists.
- Battery and UPS tests should be part of the DP annual trial programme and subject to regular maintenance.
- It should be noted that with one diesel generator on each bus, a partial black-out may occur in case of failure. This should be included in the operational activity planning.
- It appears the vessel responded as designed and the situation was well handled by the vessel crew.
Latest DP incidents
-
Know your equipment, or at least where to find the answers
During an update in the Follow Target Mode, the crew noticed an anomaly with joystick control.
DPE 02/26
1 September 2026
Observation
-
New equipment, unexpected consequences
During the operation, a loss of DGNSS correction signals was experienced across multiple vessel DGNSS units.
DPE 02/26
1 September 2026
Incident
-
A chain of small failures leads to a major consequence
While conducting cargo operations on DP a vessel experienced a partial blackout caused by an unexpected shutdown of generator 3
DPE 02/26
1 September 2026
Incident
-
Holding position, losing references
While approaching a turret-moored, weather-vaning offshore installation (FPSO), in preparation for cargo operations, a DP equipment class 2 vessel experienced significant rolling of up to 15–20° due to a long-period swell close to the vessel’s natural roll period, resulting in a resonance effect
DPE 02/26
1 September 2026
Observation
-
DP drill scenario – Loss of seawater cooling pump redundancy
Exercise scenario – Loss of seawater cooling pump redundancy
DPE 02/26
1 September 2026
Drill Scenario
The case studies and observations above have been compiled from information received by IMCA. All vessel, client, and operational data has been removed from the narrative to ensure anonymity. Case studies are not intended as guidance on the safe conduct of operations, but rather to assist vessel managers, DP operators, and technical crew.
IMCA makes every effort to ensure both the accuracy and reliability of the information, but it is not liable for any guidance and/or recommendation and/or statement herein contained.
Any queries should be directed to DP team at IMCA. Share your DP incidents with IMCA online. Sign-up to receive DP event bulletins straight to your email.
