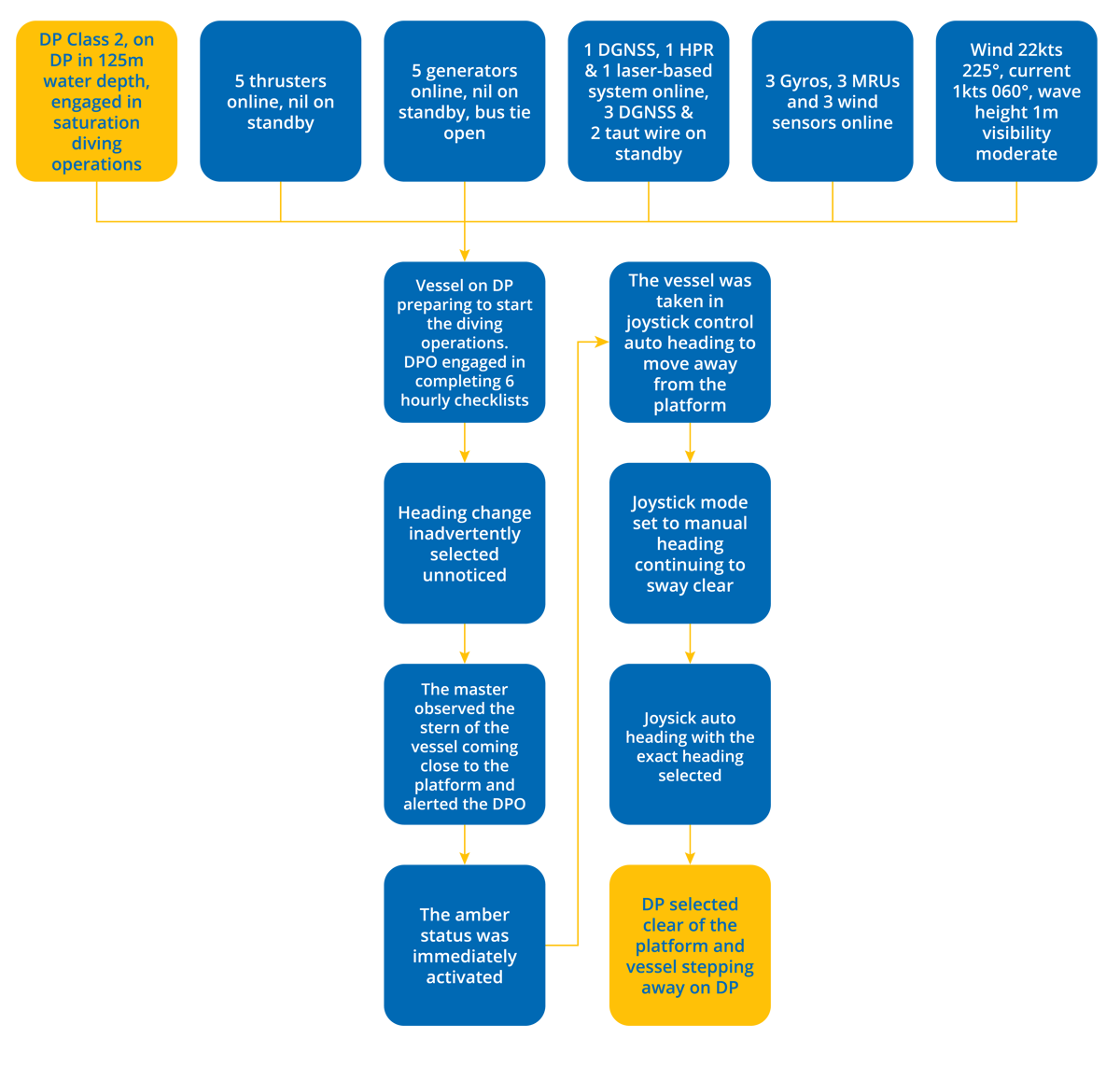

Simultaneous activities on the bridge caused a DP incident
- DP Event
- Published on 3 December 2020
- Generated on 20 May 2026
- DPE 04/20
- 1 minute read
Incident
Jump to:
The experienced DPO was new to the vessel and misinterpreted a 30 degree heading increment as being a 30 degree/min rate of turn.
Comments
The DPO, though experienced, was new to the vessel and the DP system. He had undergone familiarisation of the system but misinterpreted 30o heading increment as being a 30o/ min rate of turn. As the 6-hourly checklists were being completed, the vessel was making moves and deploying references. Multiple operations were initiated just prior to watch handover which could have been delayed by a few more minutes.
Considerations
- Bridge resource management was not properly exercised. In principle, the second DPO should fill out the checklists and the DPO at the desk should concentrate on vessel position keeping only.
- The familiarisation process should be reviewed to be more robust to ensure new DPOs are completely familiar with the desk and functions.
- Reference should be made to, The training and experience of key DP Personnel (IMCA M117).
- It should be noted that a 30o per minute rate of turn was considered to be far too high whilst engaged in diving operations.
Latest DP incidents
-
Think twice. Press once!
On a DP equipment class 2 supply vessel engaged in drilling, an incident occurred due to lack of operational knowledge
DPE 01/26
11 May 2026
Incident
-
Network issues, not a thing of the past
A DP equipment class 3 vessel was engaged in saturation diving activities, with two divers in the water when this DP incident occurred.
DPE 01/26
11 May 2026
Incident
-
All swept up
A DP equipment class 2 vessel was engaged in rock placement operations, within close proximity to a structure, when this event occurred.
DPE 01/26
11 May 2026
Undesired event
-
Hybrid system won't accept load
A DP equipment class 2 vessel was engaged in operations whilst holding position on auto DP, when this undesired event occurred
DPE 01/26
11 May 2026
Undesired event
-
DP drill scenario – Loss of main DP system UPS
The objective of this scenario is to identify risks and impacts of losing the main DP system uninterruptible power supply, possibilities to reduce that risk and suitable actions to be taken if such an occurrence happened.
DPE 01/26
11 May 2026
Drill Scenario
The case studies and observations above have been compiled from information received by IMCA. All vessel, client, and operational data has been removed from the narrative to ensure anonymity. Case studies are not intended as guidance on the safe conduct of operations, but rather to assist vessel managers, DP operators, and technical crew.
IMCA makes every effort to ensure both the accuracy and reliability of the information, but it is not liable for any guidance and/or recommendation and/or statement herein contained.
Any queries should be directed to DP team at IMCA. Share your DP incidents with IMCA online. Sign-up to receive DP event bulletins straight to your email.
