Pipe leak leads to loss of all thrusters
- DP Event
- Published on 29 November 2019
- Generated on 22 September 2026
- DPE 04/19
- 2 minute read
Incident
Jump to:

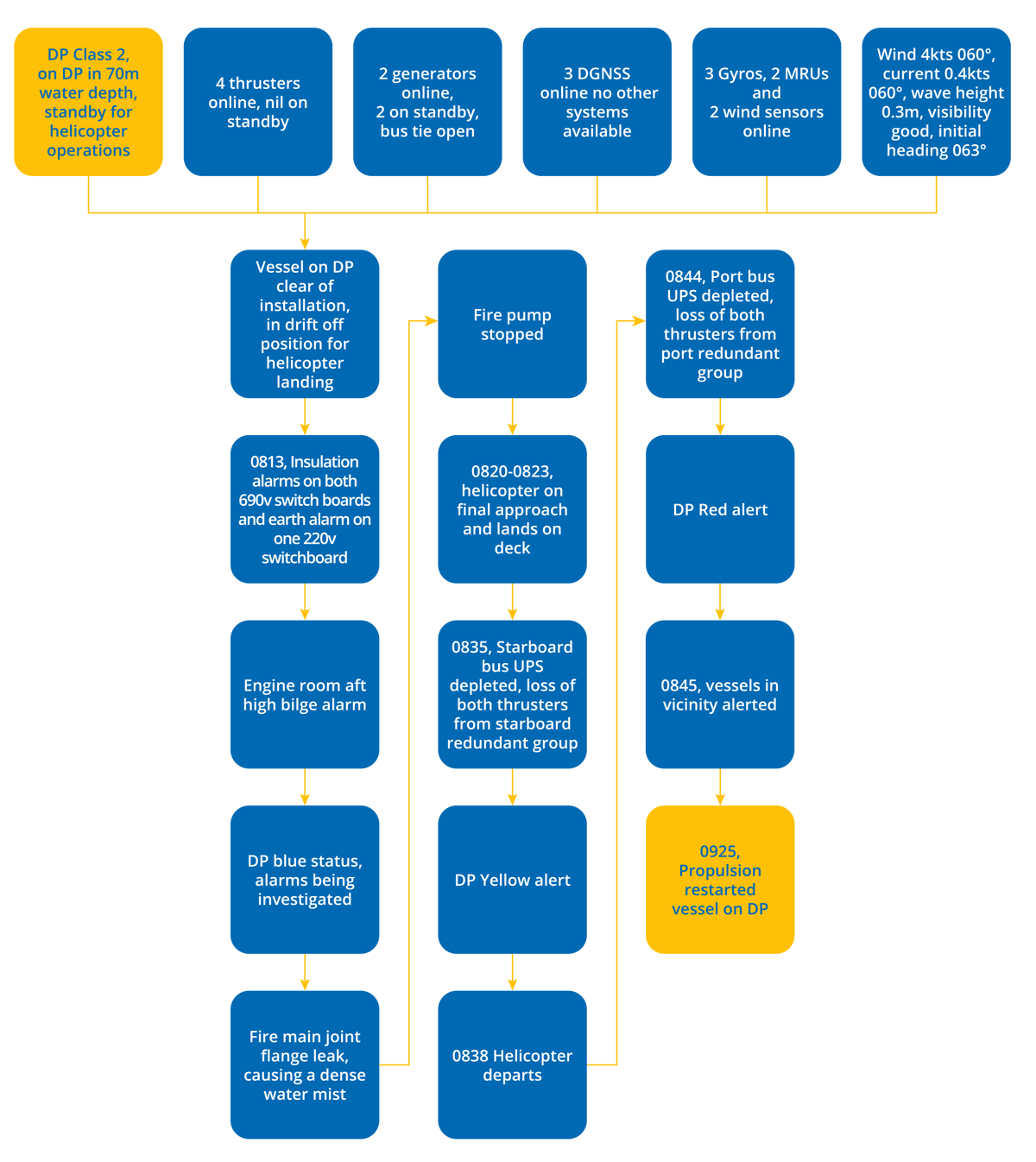

Whilst pressurising the fire main for helicopter operations, a gasket failure occurred on the pipework valve under the engine room floor.
Comments
Whilst pressurising the fire main for helicopter operations, a gasket failure occurred on the pipework valve under the engine room floor in front of transformers 690V/440V T3 and T4. The spray created a water fog and favourable atmosphere for an electric arc on T3 and T4 transformers, leading to a loss of 440v and 230v on vessel power plant. Upon depletion of the UPS batteries, the thrusters were lost.
A detailed investigation was undertaken with many findings including adding ingress protection at the transformers, adding isolation valves in the piping, and modifying procedures.
One supplementary finding related to the UPS systems, as both failed before 30 minutes. Investigation revealed that the load on the UPS’s was greater than when they were tested alongside during annual DP trials.
Considerations
- It was questioned whether the DP alarm should have been yellow rather than blue and it is assumed that, for some reason, the alarms generated at 08:13 were not interpreted correctly.
- There was concern that a fire main was passing through a transformer space. It was considered that if the vessel had been equipment class 3, it would have been subject to an assessment of the space so the danger of such an occurrence happening would have been noted.
- UPS battery endurance tests (30min check) should be performed with all UPS consumers connected and in use.
Latest DP incidents
-
Know your equipment, or at least where to find the answers
During an update in the Follow Target Mode, the crew noticed an anomaly with joystick control.
DPE 02/26
1 September 2026
Observation
-
New equipment, unexpected consequences
During the operation, a loss of DGNSS correction signals was experienced across multiple vessel DGNSS units.
DPE 02/26
1 September 2026
Incident
-
A chain of small failures leads to a major consequence
While conducting cargo operations on DP a vessel experienced a partial blackout caused by an unexpected shutdown of generator 3
DPE 02/26
1 September 2026
Incident
-
Holding position, losing references
While approaching a turret-moored, weather-vaning offshore installation (FPSO), in preparation for cargo operations, a DP equipment class 2 vessel experienced significant rolling of up to 15–20° due to a long-period swell close to the vessel’s natural roll period, resulting in a resonance effect
DPE 02/26
1 September 2026
Observation
-
DP drill scenario – Loss of seawater cooling pump redundancy
Exercise scenario – Loss of seawater cooling pump redundancy
DPE 02/26
1 September 2026
Drill Scenario
The case studies and observations above have been compiled from information received by IMCA. All vessel, client, and operational data has been removed from the narrative to ensure anonymity. Case studies are not intended as guidance on the safe conduct of operations, but rather to assist vessel managers, DP operators, and technical crew.
IMCA makes every effort to ensure both the accuracy and reliability of the information, but it is not liable for any guidance and/or recommendation and/or statement herein contained.
Any queries should be directed to DP team at IMCA. Share your DP incidents with IMCA online. Sign-up to receive DP event bulletins straight to your email.
